Did
you know, some
builders try to talk you out of getting building
inspections. You can draw your own
conclusions why they would do that. Some also want you to
use their building inspectors. You may want to ask
yourself why they want you to use them rather than someone
who is completely independent.
PCMConcepts have no
formal or informal arrangements with any builders. We are
100% independent. As such, the less professional builders
are concerned about our engagement. The more professional
builders welcome a fresh and independent set of eyes over
their work. Those are the builders that want to give you a
good product.

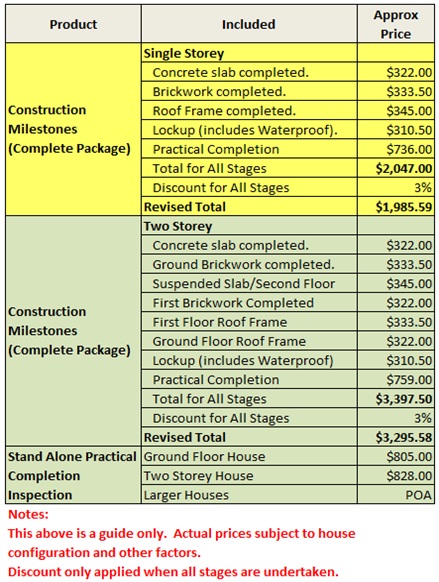

PCMConcepts offers
inspections at each stage of your build. In a single
storey traditional build, the following is the normal set
of stages and what will be inspected (ie assumes masonry
and timber roof, but others are also undertaken):
- Slab. The
condition of the slab, location, set out, location of
plumbing and other penetrations, footing thickness (one
location), cracking, deflection and dimensions.
Compliance with the engineer’s design drawings and AS2870
– Residential Slabs and Footings.
- Plate Height. The
correct number, location, type and installation of roof
tie down points and straps and other structural design
aspects are checked at plate height as well as
bricklayer workmanship, brick tie installation, physical
termite barrier, correct windows and room dimensions.
General compliance with AS4773.1 – Masonry in Small
Buildings as well as the design drawings, engineer’s
plans and the Guide to Standards and Tolerances 2019.
- Roof Structure.
Roof beams, underpurlins, hip/rafter connections, collar
tie connections, strutting, chocking, and general
construction in accordance with AS1684.2 –
Residential Timber Framed Construction. Tie down
is checked to ensure they comply with the engineer’s
design drawings and that beam sizes, locations and
connections also comply. Water services fitting is
checked to AS3500.1 and AS3500.5 – Plumbing and
Drainage.
- Lockup.
Waterproofing of wet areas to BCA. Application of wet
area screeding, window operation, ceiling heights,
cabinetry, joinery, general workmanship and location of
plumbing and electrical fittings.
- Practical Completion.
All finishes to the Guide to Standards and
Tolerances 2019, plaster to HB31 -
Building Tolerances Handbook, painting to AS2311
– Guide to Painting of Buildings. Door and door
hardware operation. Window furniture operation.
Connections, insulation, exhaust systems to National
Construction Code (Building Code of Australia) and
the design. Appliances, hot water, power, water shower
runoff to AS3740 – Waterproofing of Domestic Wet
Areas and AS3958.1 – Guide to Installation of Ceramic
Tiles. Benchtops, splashback sealing and many
other items are checked at PCI
After
each inspection, you will receive a comprehensive report
that covers off on all of the issues found. The issues
will be referenced back to the applicable part of the National
Construction Code (Building Code of Australia),
Australian Standards, the Guide to Standards and
Tolerances 2019 and the construction drawings.
